Lowther-Rolton

Heavy Lift and Transport Engineering

Established in 1987

Let Us Do The Heavy Lifting

Logistics

READ MORE

Transport

READ MORE

Construction

READ MORE

Lowther-Rolton’s services to industry: Engineering and third party assurance for your project’s lifting, rigging and transport operations

PROJECT SOLUTIONS

Here at Lowther Rolton, our Professional Engineers in the USA, UK, and Canada have an incident free track record since formation in 1987. We specialize in Professional Engineering Services for the Heavy Lift, Transportation and Construction Industries worldwide. We are consistently appointed to major construction, turnaround, revamp, and maintenance Projects.

With our expertise, we will be able to help you plan each stage of your operation and find the most appropriate solution for your unique situation. We are particularly conscious of the need to meet or improve on established schedules and budgets during Projects of the smallest size, through to largest mega-Projects.

FROM CONCEPT TO CONSTRUCTION

Our experience extends from strategy development including modularization through to lift planning and third Party assurance of all load movement schemes.

Each project is unique, and our diverse team of Engineers and Project Managers can help guide the decision-making process providing expert advice for:

As the first choice consultants throughout all phases of your Project, L-R Services meet and exceed industry standards of quality and safety. We welcome the opportunity to discuss your load movement needs.

Get connected with us today and let us help plan your next project.

Services to the Refining sector

Since 1987 Lowther-Rolton have provided our Clients with a value added service, acknowledged to raise standards of safety and efficiency throughout the Project life-cycle. With our extensive experience of alternative construction techniques such as modularization we can assist you develop and implement an optimal, practical project construction plan. We can set the standards for lifting and transport Contractors, ensuring that your program complies with legislation and meets industry best practices. Our Technical Audits ensure all technical details have been positively resolved prior to operations commencing.

Alternatively, we can prepare first party documentation including lift plans, transport arrangements and rigging designs.

Fossil, Nuclear and Renewable Energy

Since opening our USA office in 2012, Lowther-Rolton have established a first class reputation for our Technical Audits (T/A) of equipment installations, removals and changeouts for the Power Generation sector.

Our T/A checks ensure that the assurance requirements of Plant owners are satisfied, and that all engineering aspects and interfaces are positively resolved in advance of operations.

Our Clients have come to rely on us to support safe and efficient construction and outage Projects.

Lowther-Rolton is the premier independent engineering consultancy for Heavy Lift & Construction Engineering, providing original in-house design and third-party verification services.

BP Whiting Modernization Project (WRMP): 2009 - 2014

Installation of the Main Crude Column at the 12 Pipe Still Unit

Project Statistics:
● Approximately 1,000 process equipment items reviewed, handled, delivered and installed
● Module deliveries from 3 fabrication yards (USA and Asia locations)
● Modules up to 560 Metric Tonnes
● Vessels up to 950 Metric Tonnes
● Installations utilizing heavy craneage and SPMT, combined with tailing frames, together with slide and jacking systems

Lowther-Rolton Provided Engineering Expertise for the Modernization of BP’s Whiting Refinery

The Whiting Refinery Modernization Project represented a major strategic investment for BP, and to ensure a safe, efficient and successful completion of the heavy lift and transportation (HLT) program BP engaged Lowther-Rolton (L-R) to provide independent third party verification including construction concept advice and oversight, together with associated engineering services during shipping, transportation and installation of the process equipment.

L-R assisted BP and their EPC contractors to set and achieve high and consistent standards across all HLT activities of each project ‘Pillar’, initially by coordinating the authorship of the Project’s Rigging, Lifting and Heavy Haul
Procedure.

The Technical Audit process, first devised by L-R in the 1990’s, was employed to check and verify the lifting, shipping and transportation studies for each movement of process equipment together with associated engineering aspects
including, but not limited to, design of lifting attachments, integrity of module structures and ground preparation relating to the lift, shipping and transport proposals.

Lowther-Rolton’s engineers assigned to site, and other locations in USA and globally, ensured that accepted HLT studies were adhered to and accurately implemented, that a rigorously controlled Management of Change process was completed, where necessary, due to altered conditions, or where opportunities to employ improved safe methods were identified.

During the Project L-R became the problem solvers for all HLT matters, and remained engaged both on site and for desk based review work all the way through to the plant start-up and commissioning phase.

Over a four year delivery and installation period all lifting activities of process equipment items, in and around Whiting Refinery, were successfully completed without incident.

Installation of fully dressed Crude Column

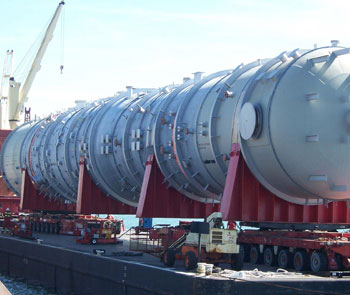

Trans-shipping 560 Metric Tonne module from ship to barge

Lowther-Rolton Established and Harmonized Project Standards

Lowther-Rolton’s introduction to the Project was by request to attend the PEER review meeting at Whiting to assist BP determine the viability of the Project coupled with the construction philosophy of modularization.

Due to the scale of the Project, BP divided the work into four “Pillars” , each associated with a particular process unit and EPC contractor. HLT operations took place at the Whiting refinery, domestic and overseas fabrication facilities and port locations. At Whiting refinery a significant amount of the HLT work was located in or adjacent to live plant areas.

A diverse equipment list, including numerous pressure vessels, process modules, piperacks, pre-assemblies, rotating equipment and vendor packages, was mobilized to site for installation. The majority of equipment items were handled on multiple occasions including pressure vessels which were delivered bare and subsequently dressed on site, leading to modified characteristics. Considering the size and complexity of the HLT challenge presented by the Project, BP identified that to achieve the twin aims of efficient progress and safe, controlled HLT operations, a shared process for planning, acceptance and execution across all contractors and locations was required.

At BP request Lowther-Rolton partnered with Refinery and Project stakeholders to conceive, coordinate, create, issue and implement a Rigging, Lifting and Heavy Haul Procedure, which complied with the BP Golden Rules of Safety, industry/regulatory standards and established best practices.

Roles and responsibilities together with personnel qualifications, inspection, certification and testing requirements to meet BP and Whiting Refinery requirements were also incorporated.

Together with setting standards for the engineering and operational activities, the procedure specified the Project’s HLT engineering documentation and review requirements, using a system which analyzed the risk profile of each individual operation and defined documentation requirements and protocols for approval accordingly.

Lowther-Rolton worked with all stakeholders tailoring the procedure to integrate seamlessly with the Project’s Hazard Identification/Task Risk Assessment and permitting systems, providing a controlled environment during engineering and planning, thereby minimizing potential delays during permitting with the result that correct, complete, audited and accepted planning was complete to meet construction schedule requirements in advance of each operation.

Based on experience from previous projects L-R included provision for flexibility within the system to accommodate required changes to agreed plans, by incorporating Management of Change, thereby ensuring that risks would continue to be identified and mitigated, with control measures accepted, recorded and implemented prior to operations continuing.

A simplified lift planning and checking process was also devised and implemented for less complex lifting operations, to ensure that sufficient consideration had been offered to a less complex/simple lifting operation.

L-R Scope of Work Summary:

● Attend the PEER review meeting (2007) to assist authorize the Project
● Coordinate the creation of the Project Rigging, Lifting and Heavy Haul Procedure.
● Technical Audit desk study of lifting, shipping and transportation studies for all process equipment items over 25 US tons

● Attend the loadouts at 3 fabrication yards (USA and Asia locations) and Vendor locations world-wide
● Attendance at trans-shipment and barge roll-off operations
● Attendance during equipment installation by craneage, transporters and slide and jack methods
● Technical support to the Project to completion

Lowther-Rolton’s Technical Audit System

Throughout the WRMP and in accordance with the Project Rigging, Lifting and Heavy Haul Procedure, the engineered plan for each HLT operation involving a process equipment item weighing over 25 US tons was subjected to L-R’s comprehensive Technical Audit (T/A).

L-R’s T/A process considered the shipping, transportation and lifting studies prepared by others from the various EPC’s and associated contractors together with Vendor design information, geo-technical reports, weighing and survey reports and additional information reported by our construction oversight team.

Following our review the plans were returned to the originators to be revised and completed as required, prior to further and final reviews. The T/A process ensured that operations were fully defined and able to be completed safely, and efficiently, with minimal risk to personnel and plant.

Lowther-Rolton’s proactive approach to the T/A process ensured that the comments returned provided positive support to the EPC and other associated organizations producing original engineering, injecting quality in addition to reducing the number of review cycles required to reach a complete and accept an engineering package.

The scope of the Technical Audit encompassed associated engineering aspects such as design of lifting and tailing attachments, base ring stiffening, global stresses in process equipment, ground loads and analysis of weight data obtained from load cell readings. As such many interface issues and discrepancies uncovered were able to be corrected during the planning and engineering phase, prior to operations commencing.

This Technical Audit process was completed prior to the plans being presented to BP Project and Construction management committees at the appropriate level for their approval. This process ensured that the Asset approval process for each Pilar was streamlined and successful. The T/A therefore added value by saving management time and protecting the construction schedule, in addition to the safe execution of the work.

As part of the Technical Audit L-R’s oversight team attended ship loading/discharging and trans-ship, barge roll-on/off and process equipment installation operations whether at the construction site or at USA domestic or overseas fabrication/Vendor facilities. Our experienced senior staff ensured that accepted plans were implemented per the documentation and expedited adjustments under the formal Management of Change requirements set by the Project.

The T/A was a major part of BP’s risk management for the HLT aspect of the Project, which ultimately led to Lowther-Rolton’s presence continuing into the start-up and commissioning phase, ensuring the final heavy equipment items, during the planned turnaround, were delivered and installed without incident or delay.

What Can You Expect From Us

First Party Design

Project Management

Third-Party Verification Services

Sectors Served

learn more about our scope of services

Services of Interest:

Logistics

ASK US ABOUT:

  • Movement from manufacturer to point of installation
  • Selection of transport and lifting methods
  • Procurement support/technical evaluation of Contractor proposals
  • Optimized module weights and dimensions
  • Lifted loadouts
  • Roll-on/Roll-off operations
  • Barge operations, stowage, lashing and ballasting
  • Bridge strength
  • Rail Car loading and securement
  • Feasibility studies
  • Loadout and stowage drawings
  • Lashing and Securing calculations
  • PE sealed design packages
  • Technical site supervision by our experts
  • Third Party review and Technical Audit
  • Trans-shipment

Transport

ASK US ABOUT:

  • Transporter stability calculations
  • Cargo securement
  • Transporter axle loads and ground pressure
  • Route survey and bridge strength
  • Route upgrades and civil improvements
  • Rail Car loading and securement
  • Feasibility studies
  • Transport drawings
  • Trans-shipment using Gantry
  • PE sealed design packages
  • Technical site supervision by our experts
  • Third Party review and Technical Audit
  • Roll-on/Roll-off operations
  • Procurement support/technical evaluation of Contractor proposals

Construction

ASK US ABOUT:

  • Crane selection and availability, capacity
  • Lift plan drawings
  • Rigging arrangements
  • Ground bearing pressure study
  • Allowable wind speed checks
  • Alternative lifting methods (lift systems, jacking/skidding, gantry)
  • Installation using SPMT
  • Third Party review and Technical Audit
  • Proof load test requirements
  • Procurement/Contractor selection support
  • Construction sequence and schedule
  • Technical site supervision by our experts
  • Modularization
  • Procurement support/technical evaluation of Contractor proposals
  • OSHA compliance checks

Design

ASK US ABOUT:

  • PE sealed design packages
  • Design and analysis of special structures
  • Transporter stability calculations
  • Transporter axle loads and ground pressure
  • Lift plan and rigging drawings
  • Rigging calculations & rigging component design
  • Analysis of temporary load cases for load movement
  • Outrigger and crawler loads
  • Allowable ground bearing pressure
  • Third Party design checks
  • 3D structural modelling and FEA
  • Crane mats and loadspreading calculations
  • ASME/OSHA/British Standards compliance
  • Pressure vessel and lifting attachment design
  • Strand jack and tower lift system design
